ECLSS for Gaganyaan
India's Crewed Life Support

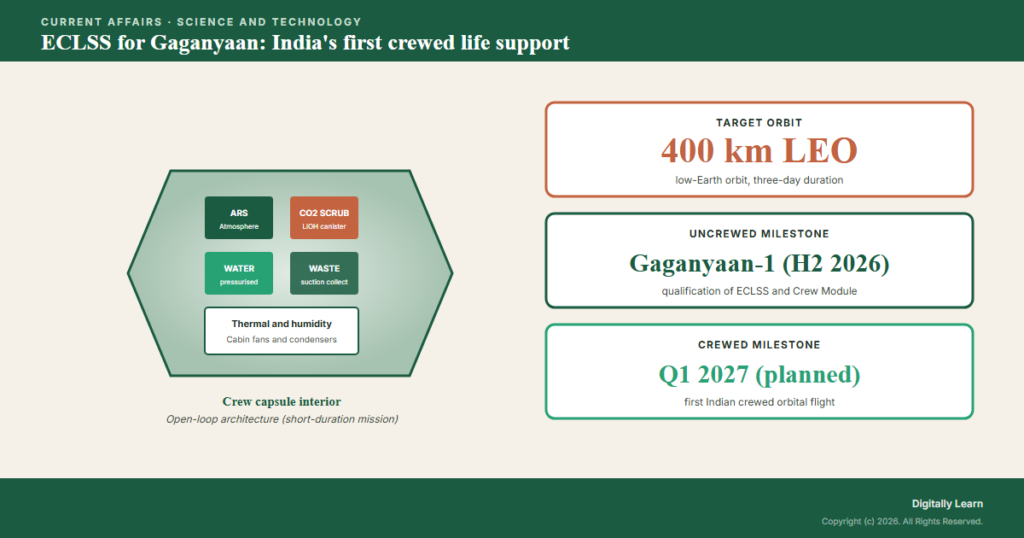

ISRO detailed the indigenous life-support system for Gaganyaan: open-loop oxygen, CO2, water and waste for low-Earth orbit.

400 km LEO target3 crew for 3 daysQ1 2027 first crewed
At a glance
ECLSSBuilt indigenously at VSSC, Thiruvananthapuram
ArchitectureOpen-loop; consumables carried from Earth
4 subsystemsARS, thermal-humidity, water, waste
Gaganyaan-1Uncrewed qualification flight in H2 2026
digitallylearn.comUPSC-CSE Current Affairs

Previous Year UPSC-CSE Questions By the end you will be able to draft model answers for the following UPSC questions. Each question carries a collapsible framework showing how to approach it in the exam.

  1. UPSC Mains 2019 GS-IIIWhat is India’s plan to have its own space station and how will it benefit our space programme?
    How to structure the answer in the exam

    Directive verb: Examine plan and assess benefits · Approach: Open with the 2024 Prime Ministerial announcement of the Bharatiya Antariksha Station (BAS) and the 2028 first-module / 2035 full-operational milestones; explain the plan through three layers (modular architecture, supporting infrastructure, partnership ecosystem); assess benefits through four channels (technology, employment, science, prestige). Close with ECLSS as the foundational competence the BAS builds on. · Word count: 150

    Introduction: Open with the 2024 announcement of the Bharatiya Antariksha Station (BAS), name the 2028 first-module-launch and 2035 operational-status targets, and frame the answer through plan architecture and benefit channels.

    Body (sub-themes to develop):

    • Plan architecture: BAS as a five-module low-Earth-orbit space station; first module BAS-01 of approximately 10 tonnes launched on LVM3 in 2028, building to a full assembled mass near 52 tonnes; orbit altitude in the 400-450 km LEO band; remaining modules added through the Next Generation Launch Vehicle.
    • Supporting infrastructure: ECLSS (Environmental Control and Life Support System) developed at VSSC for Gaganyaan as the foundational life-support competence; closed-loop ECLSS upgrade for multi-week BAS occupancy; CE-20 cryogenic upper stage upgraded and human-rated.
    • Partnership ecosystem: NASA-ISRO Axiom-4 mission of 2025 with Group Captain Shubhanshu Shukla to the ISS; Russian Roscosmos support for Gaganyatri training; potential ESA and JAXA module partnerships for BAS.
    • Benefit channel 1 (technology): closed-loop life-support, on-orbit assembly, long-duration crew operations; spin-off applications in submarine life support, biosafety containment.
    • Benefit channel 2 (employment): high-skill aerospace employment across VSSC, HSFC, ISTRAC; private-sector NewSpace India Ltd subcontracting cycle.
    • Benefit channel 3 (science): microgravity experiments in materials, life sciences, plasma physics; Earth observation and astronomy missions hosted on the platform.
    • Benefit channel 4 (strategic): India joins the small set of countries with own space stations (USA via ISS leadership, Russia via ROSS, China via Tiangong).

    Conclusion: Conclude that India's space-station plan rests on a modular LEO architecture targeting 2028 first-module and 2035 full operation, that the Gaganyaan ECLSS is the foundational life-support competence the BAS builds on, and that benefits span technology, employment, science, and strategic-autonomy channels.

    The Gaganyaan ECLSS is the foundational life-support competence that the Bharatiya Antariksha Station 2024-announced plan builds on. The body sub-theme on supporting infrastructure supplies the leading 2026-current evidence pillar.

  2. UPSC Mains 2023 GS-IIIWhat is the main task of India’s third moon mission which could not be achieved in its earlier mission? List the countries that have achieved this task. Introduce the subsystems in the spacecraft launched and explain the role of the ‘Virtual Launch Control Centre’ at the Vikram Sarabhai Space Centre which contributed to the successful launch from Sriharikota.
    How to structure the answer in the exam

    Directive verb: Identify task, list countries, introduce subsystems, explain VLCC role · Approach: Open with Chandrayaan-3 (July 2023) and the south-pole soft-landing goal that Chandrayaan-2 (2019) missed; list the four countries that have soft-landed on the Moon; introduce Chandrayaan-3 subsystems (Lander Vikram, Rover Pragyan, Propulsion Module); explain VLCC's role at VSSC. Bridge to Gaganyaan ECLSS as the crewed-counterpart subsystem suite. · Word count: 250

    Introduction: Open with the Chandrayaan-3 mission of July 2023, name the lunar south-pole soft-landing goal that Chandrayaan-2 of 2019 could not achieve, and frame the answer through task-country-subsystem-VLCC components.

    Body (sub-themes to develop):

    • Main task: lunar south-pole soft landing; achieved on 23 August 2023 at the Shiv Shakti Point (latitude approximately 69 degrees south).
    • Earlier-mission failure: Chandrayaan-2 lander Vikram crashed on 6 September 2019 due to a thrust-and-orientation control-loop issue during the final descent.
    • Countries that have achieved lunar soft landing: USA, USSR/Russia, China, and now India (USA and USSR achieved it in the 1960s-70s, China with Chang'e-3 in 2013, India with Chandrayaan-3 in 2023).
    • Chandrayaan-3 subsystems: Lander Vikram with redundant sensors and four-throttleable engines; Rover Pragyan with six-wheel drive and onboard payloads (APXS, LIBS); Propulsion Module that ferried the lander-rover to lunar orbit and now serves as a relay platform.
    • Virtual Launch Control Centre (VLCC) at VSSC: digital-twin simulation of the LVM3 launch vehicle and the spacecraft, used for pre-launch dry-run rehearsals and contingency planning; reduces launch-day risk through scenario-coverage.
    • Bridge to Gaganyaan: the subsystem-introduction frame extends naturally to the Gaganyaan ECLSS as the crewed-mission life-support counterpart that VSSC also developed.

    Conclusion: Conclude that Chandrayaan-3 achieved the lunar south-pole soft-landing task Chandrayaan-2 missed, that the subsystems and VLCC together composed the mission stack, and that the next step on the Indian space ladder is Gaganyaan with the ECLSS as the headline crewed-mission subsystem.

    The Gaganyaan ECLSS is the crewed-mission counterpart of the Chandrayaan-3 subsystem stack the 2023 GS-III question asks examinees to introduce. The body sub-theme on bridge to Gaganyaan supplies the 2026-current extension.

The Environmental Control and Life Support System (ECLSS) is the cluster of subsystems on a crewed spacecraft that maintains a habitable cabin atmosphere, supplies drinking water, manages metabolic waste, regulates temperature and humidity, and protects the crew and onboard electronics from the harsh space environment. For the Gaganyaan crewed mission, ISRO has designed and built the ECLSS indigenously at the Vikram Sarabhai Space Centre (VSSC), Thiruvananthapuram, using an open-loop architecture suited to short-duration low-Earth-orbit missions.

Why this is in the news on 22 May 2026

The ECLSS architecture detailed and the Gaganyaan-1 timeline

On 22 May 2026, ISRO surfaced a detailed technical briefing on the Environmental Control and Life Support System (ECLSS) developed for the Gaganyaan crewed orbital mission. The briefing coincided with the ISRO Chief V. Narayanan's update that the uncrewed Gaganyaan-1 mission is on track for second half of 2026, with the first crewed flight slated for the first quarter of 2027.

Definition: The ECLSS is the integrated cluster of subsystems on a crewed spacecraft that maintains a habitable cabin atmosphere, supplies water, manages metabolic waste, controls temperature and humidity, and protects crew physiology and onboard electronics. Indian ECLSS for Gaganyaan was designed and built at Vikram Sarabhai Space Centre (VSSC).

Three structural pillars define the Indian ECLSS:

  1. (i) Open-loop architecture. All human supplies (oxygen, water, food) are carried from Earth at launch, and metabolic waste is collected, stabilised, and stored for post-mission disposal. The open-loop design is appropriate for short-duration missions; closed-loop systems with on-orbit recycling are reserved for long-duration platforms such as the International Space Station.
  2. (ii) Four functional subsystems. The Atmosphere Revitalization System (ARS) supplies oxygen and scrubs carbon dioxide. The Thermal and Humidity Control System manages cabin temperature and moisture via fans and condensers. The Water Subsystem stores and delivers pressurised drinking water. The Waste Management Subsystem uses suction-based collection with chemical treatment in microgravity.
  3. (iii) Mission-target envelope. The crew capsule supports a three-member crew in a 400 kilometre low-Earth-orbit (LEO) trajectory for a three-day mission duration. The ECLSS is qualified for this envelope; longer durations or higher altitudes would require an upgraded closed-loop architecture.

Why an indigenous ECLSS matters for India's crewed-spaceflight capability

Strategic-autonomy in human-spaceflight technology

Why it matters: An indigenous ECLSS matters because crewed-spaceflight life support is the highest-criticality space subsystem: a failure does not produce a lost satellite but a lost crew. Only three space agencies have flown indigenous crewed life-support systems: NASA (Mercury through Artemis), the Soviet Union and Russia (Vostok through Soyuz), and China (Shenzhou). India joins this short list with Gaganyaan.

The system also matters because life-support technology has spin-off applications in submarine life support, high-altitude aviation, biosafety laboratory containment, and tunnel-and-mine ventilation. The ECLSS development cycle deepens the Indian aerospace-life-sciences set of capabilities beyond the immediate Gaganyaan use case.

Four functional subsystems of the ECLSSOpen-loop architecture for short-duration LEO missionsAtmosphere RevitalizationSystem (ARS)Oxygen supply from onboard tanksLithium hydroxide CO2 scrubbingActivated charcoal odour filtersInternal cabin fans drive airflowThermal and HumidityControl SystemCabin air temperature regulationCondensers remove cabin moistureHeat rejection through radiatorsCrew comfort and electronics survivalWater SubsystemPressurised drinking waterStorage in onboard tanksNo on-orbit recycling (open-loop)Hygiene water carried separatelyWaste Management SubsystemSuction-based collectionChemical treatment of wasteStored for post-mission disposalMicrogravity-specific designFigure 1. Four functional subsystems of the Gaganyaan ECLSSDigitally LearnCopyright (c) 2026. All Rights Reserved.

Significance for India's space-station programme and human-spaceflight ladder

What the ECLSS milestone signals for the Bharatiya Antariksha Station and the crewed-Moon track

What is the significance of this issue: The ECLSS readiness milestone carries three significances for India's human-spaceflight strategy:

  1. (i) Space-station-programme signal. The Indian Bharatiya Antariksha Station (BAS) announced in 2024 targets first-module launch by 2028 and full operational status by 2035. Closed-loop ECLSS is a precondition for a multi-week BAS deployment; the open-loop Gaganyaan ECLSS is the foundational competence on which the closed-loop upgrade builds.
  2. (ii) Crewed-mission-ladder signal. ISRO’s manned-mission roadmap moves from Gaganyaan (3-day LEO, 2026-27) through a seven-day extended mission in the post-2027 window to BAS module-tending crewed flights by the early 2030s, and a crewed lunar landing by the 2040 target. Each ladder rung requires a successively more capable ECLSS.
  3. (iii) Indigenisation-and-export signal. ECLSS hardware sits in the Defence Acquisition Procedure’s positive-indigenisation trajectory; aerospace-life-sciences capabilities are spin-off enablers for submarine atmospheres, high-altitude UAV payloads, and biosafety-level-4 (BSL-4) laboratory containment systems.

The Indian crewed-spaceflight mission ladder

Indian crewed-spaceflight mission ladderGaganyaan to Bharatiya Antariksha Station to lunar landingH2 2026Gaganyaan-1uncrewedQ1 2027Gaganyaan crewed3 crew, 3 dayspost-2027Extended mission7-day duration2028BAS module 1first launch2035BAS operationalmulti-module station2040Crewed Moontarget landingEach ladder rung requires successively more capable life-support architecture.Figure 2. Indian crewed-spaceflight mission ladderDigitally LearnCopyright (c) 2026. All Rights Reserved.

Distinguishing features of the Gaganyaan ECLSS

The three engineering pillars of the Gaganyaan ECLSS

Distinguishing features: Three engineering pillars define the ECLSS implementation:

  1. (i) Pressure and atmosphere envelope. The cabin holds a sea-level-equivalent pressure (101.3 kilopascals nominal) with a nitrogen-oxygen mixture at near-Earth ratios. Partial-pressure of oxygen and carbon-dioxide are monitored continuously; the ARS responds dynamically to crew metabolic load.
  2. (ii) Lithium-hydroxide carbon-dioxide scrubbing. Crew CO2 exhalation is absorbed by lithium hydroxide (LiOH) canisters via the irreversible reaction 2 LiOH and CO2 yields Li2CO3 and H2O. Spent canisters are stored; this is the open-loop signature.
  3. (iii) Microgravity waste-management. Suction-airflow draws metabolic waste into containment; chemical fixatives stabilise the waste for the duration of the mission. The architecture mirrors the Soyuz toilet system but uses indigenous valves, pumps, and consumables.

The Gaganyaan ECLSS specifications at a glance

Specification Detail Significance
System Environmental Control and Life Support System (ECLSS) ISRO indigenous design at VSSC
Architecture Open-loop (single-use consumables) Suited to short-duration missions
Subsystems ARS, Thermal-and-Humidity, Water, Waste Management Four functional clusters
CO2 scrubbing Lithium hydroxide (LiOH) canisters Irreversible reaction; canisters stored
Cabin pressure Sea-level equivalent 101.3 kPa nominal Crew physiology comfort
Mission target Three-member crew; 400 km LEO; three-day duration Gaganyaan mission envelope
Uncrewed milestone Gaganyaan-1 in H2 2026 Qualification flight
Crewed milestone First crewed flight Q1 2027 (planned) First Indian crewed orbital flight
ISRO Chief briefing V. Narayanan, May 2026 update Programme status confirmation
Design centre Vikram Sarabhai Space Centre (VSSC), Thiruvananthapuram ISRO lead centre for launch vehicles and life support

Observable outcomes to track from now to first crewed flight

What to watch from H2 2026 through the first crewed flight

Observable outcomes: Five outcomes frame the trajectory from the present to the first crewed flight:

  • (a) Gaganyaan-1 uncrewed launch. Whether the uncrewed flight in H2 2026 clears the launch-vehicle, crew-module, and ECLSS qualification campaign on the planned timeline.
  • (b) Crew Escape System. Demonstrated performance of the abort sequence under simulated launch-failure conditions; pad-abort tests completed and high-altitude abort tests planned.
  • (c) Crew training certification. Completion of Gaganyatri training cycles for the four selected astronauts at the Indian Astronaut Training Facility, IISc Bengaluru, and partner facilities in Russia.
  • (d) Service Module readiness. Propulsion and avionics integration of the Service Module that supplies power, thermal control, and propulsion to the Crew Module.
  • (e) Mission Control Centre infrastructure. Crewed-mission communication and tracking architecture across the Indian Deep Space Network at Byalalu, the Mission Control Centre at ISTRAC Bengaluru, and partner ground stations.

Threads connecting ECLSS to wider human-spaceflight policy

How ECLSS connects to BAS, the Chandrayaan lunar track, and international partnerships

Contemporary linkages: Three threads connect the ECLSS readiness milestone to wider Indian human-spaceflight policy.

The first is the Bharatiya Antariksha Station thread. The BAS announced in 2024 by the Prime Minister targets a first-module launch in 2028 and operational status by 2035. Closed-loop ECLSS for multi-week occupancy is the technical precondition that the present open-loop Gaganyaan ECLSS leads into.

The second is the Chandrayaan-lunar-landing thread. The Indian crewed Moon-landing target of 2040 requires a deep-space-capable ECLSS with redundancy, radiation protection, and longer mission-duration buffers. The Chandrayaan-3 south-pole landing of 2023 seeded the planetary-surface operations heritage; ECLSS adds the human-survival layer.

The third is the international-partnership thread. The NASA-ISRO Axiom-4 partnership flew Indian astronaut Group Captain Shubhanshu Shukla to the International Space Station in 2025 for a short-duration mission; the experience informs Indian ECLSS design choices and crew training protocols. Russian-Roscosmos partnership on Gaganyatri training is the other operating partnership.

ISRO centre architecture for human spaceflightFive centres supporting the Gaganyaan programmeVSSC – ThiruvananthapuramLaunch vehicles and ECLSSVikram Sarabhai Space Centre; lead for LVM3 and life supportHSFC – BengaluruProgramme coordinationHuman Space Flight Centre; Gaganyatri training facilityISTRAC – BengaluruMission Control CentreSatellite Tracking and Range Centre; Mission Control for crewed flightIPRC – MahendragiriCryogenic propulsionISRO Propulsion Complex; CE-20 engine test benchSDSC-SHAR – SriharikotaLaunch operationsSatish Dhawan Space Centre; LVM3 launchesFigure 3. ISRO's centre architecture for theDigitally LearnCopyright (c) 2026. All Rights Reserved.

UPSC Relevance

Where the ECLSS readiness sits in the UPSC syllabus

UPSC context: The ECLSS readiness milestone falls within General Studies Paper III under awareness in the fields of IT, Space, Computers, robotics, nano-technology, bio-technology, and achievements of Indians in science and technology; indigenization of technology and developing new technology. The crewed-mission dimension also touches security challenges and their management in border areas through ISRO's geospatial capabilities.

Prelims relevance: The Prelims surface includes ECLSS full form (Environmental Control and Life Support System), the four subsystems (ARS, Thermal and Humidity, Water, Waste Management), the open-loop architecture, the lithium hydroxide CO2 scrubbing chemistry, the 400 kilometre LEO target, the three-day duration, Gaganyaan-1 uncrewed H2 2026, crewed flight Q1 2027, and the Bharatiya Antariksha Station 2028 first-module and 2035 operational targets.

Mains relevance: Two framings dominate the Mains-paper surface:

  1. (i) Space-station-and-benefits framing. India’s plan to have its own space station (Bharatiya Antariksha Station) and the benefits for the space programme. ECLSS is the foundational life-support competence the BAS programme builds on.
  2. (ii) Subsystems-and-launch-architecture framing. The subsystems on Indian crewed and uncrewed missions. The Gaganyaan Crew Module, Service Module, and ECLSS together compose the crewed-mission subsystem stack.

Mains practice question: A focused fifteen-mark question would read: The Environmental Control and Life Support System (ECLSS) developed by ISRO for the Gaganyaan mission is the foundational life-support competence for India's crewed-spaceflight ladder. Examine its open-loop architecture and discuss its role in the Bharatiya Antariksha Station programme.

  • Past Mains linkage. 2019 GS-III Q6: What is India’s plan to have its own space station and how will it benefit our space programme? The ECLSS for Gaganyaan is the foundational competence for the BAS programme that the 2019 question anticipated.
  • Past Mains linkage. 2023 GS-III Q16: What is the main task of India’s third moon mission which could not be achieved in its earlier mission? List the countries that have achieved this task. Introduce the subsystems in the spacecraft launched and explain the role of the ‘Virtual Launch Control Centre’ at the Vikram Sarabhai Space Centre which contributed to the successful launch from Sriharikota. The subsystem-introduction frame extends naturally to the Gaganyaan ECLSS as the crewed-mission counterpart.
  • Related-mission linkage. Prelims questions on Chandrayaan-3, Aditya-L1, Shukrayaan, and LVM3 test the institutional surface that Gaganyaan and ECLSS sit within.

Prelims MCQ practice

Each question below tests one specific concept on the topic. Click to reveal the answer and a full option-wise explanation.

Q1. With reference to the Environmental Control and Life Support System (ECLSS) developed by ISRO for the Gaganyaan mission, consider the following statements:

  1. It uses an open-loop architecture in which consumables are carried from Earth and waste is stored for post-mission disposal.
  2. It is designed and built at the Vikram Sarabhai Space Centre, Thiruvananthapuram.
  3. It is qualified for a 400 kilometre low-Earth-orbit envelope with a three-day mission duration.

Which of the statements given above is/are correct?

  1. 1 only
  2. 1 and 2 only
  3. 2 and 3 only
  4. 1, 2, and 3
Show answer and explanation

Answer: 1, 2, and 3

Explanation.

Statement 1 is correct. The Gaganyaan ECLSS uses an open-loop architecture suitable for short-duration missions, with consumables carried from Earth and metabolic waste stabilised and stored. Statement 2 is correct. It is designed and built at the Vikram Sarabhai Space Centre (VSSC), Thiruvananthapuram, the ISRO lead centre for launch vehicles and life support. Statement 3 is correct. The system is qualified for a three-member crew in a 400 km low-Earth orbit for a three-day mission duration. All three statements are accurate, hence option (d).

Q2. With reference to the four functional subsystems of the Gaganyaan ECLSS, consider the following statements:

  1. The Atmosphere Revitalization System (ARS) supplies oxygen and scrubs carbon dioxide.
  2. The Thermal and Humidity Control System manages cabin temperature and moisture levels.
  3. The Waste Management Subsystem uses gravity-based separation for collection.

Which of the statements given above is/are correct?

  1. 1 only
  2. 1 and 2 only
  3. 2 and 3 only
  4. 1, 2, and 3
Show answer and explanation

Answer: 1 and 2 only

Explanation.

Statement 1 is correct. The Atmosphere Revitalization System (ARS) supplies oxygen from onboard tanks and scrubs carbon dioxide using lithium hydroxide canisters. Statement 2 is correct. The Thermal and Humidity Control System manages cabin temperature and moisture levels through cabin fans, condensers, and radiators. Statement 3 is incorrect. The Waste Management Subsystem uses SUCTION-based collection (negative-pressure airflow), NOT gravity-based separation, because in microgravity there is no effective gravitational separation. Hence option (b).

Q3. With reference to lithium hydroxide (LiOH) used in spacecraft life-support systems, consider the following statements:

  1. It absorbs carbon dioxide through an irreversible chemical reaction.
  2. Spent canisters are regenerated on orbit for reuse in subsequent missions.
  3. It is also used in nuclear submarines for carbon-dioxide removal in sealed crew compartments.

Which of the statements given above is/are correct?

  1. 1 only
  2. 1 and 3 only
  3. 2 and 3 only
  4. 1, 2, and 3
Show answer and explanation

Answer: 1 and 3 only

Explanation.

Statement 1 is correct. Lithium hydroxide absorbs carbon dioxide through the irreversible reaction 2 LiOH and CO2 yields Li2CO3 and H2O. Statement 2 is incorrect. Spent LiOH canisters are NOT regenerated on orbit; they are stored for the rest of the mission and disposed after return. Regenerative CO2 removal uses different technologies such as molecular sieves or the Sabatier reactor on the International Space Station. Statement 3 is correct. Lithium hydroxide is widely used in nuclear submarines for CO2 removal in sealed crew compartments during underwater patrol. Hence option (b).

Q4. With reference to the Gaganyaan mission timeline, consider the following statements:

  1. The uncrewed Gaganyaan-1 mission is scheduled for the second half of 2026.
  2. The first crewed Gaganyaan flight is currently planned for the first quarter of 2027.
  3. The Bharatiya Antariksha Station first module is targeted for launch in 2028.

Which of the statements given above is/are correct?

  1. 1 only
  2. 1 and 2 only
  3. 2 and 3 only
  4. 1, 2, and 3
Show answer and explanation

Answer: 1, 2, and 3

Explanation.

Statement 1 is correct. The uncrewed Gaganyaan-1 mission is scheduled for the second half of 2026 as the qualification flight for the crew module and ECLSS. Statement 2 is correct. The first crewed Gaganyaan flight is currently planned for the first quarter of 2027, as confirmed by ISRO Chief V. Narayanan. Statement 3 is correct. The Bharatiya Antariksha Station (BAS) first module is targeted for launch in 2028, with full operational status by 2035. All three statements are accurate, hence option (d).

Q5. With reference to the Vikram Sarabhai Space Centre (VSSC), consider the following statements:

  1. It is located in Thiruvananthapuram, Kerala.
  2. It is the lead ISRO centre for launch vehicle design and life support development.
  3. It is named after the founding Chairman of the Indian Space Research Organisation.

Which of the statements given above is/are correct?

  1. 1 only
  2. 1 and 2 only
  3. 2 and 3 only
  4. 1, 2, and 3
Show answer and explanation

Answer: 1, 2, and 3

Explanation.

Statement 1 is correct. The Vikram Sarabhai Space Centre (VSSC) is located in Thiruvananthapuram, Kerala. Statement 2 is correct. It is the lead ISRO centre for launch vehicle design (SLV, PSLV, GSLV, LVM3) and now life support development for Gaganyaan. Statement 3 is correct. It is named after Dr Vikram Sarabhai, widely regarded as the father of the Indian space programme and the founding Chairman of ISRO (1969-1971); he had earlier chaired the Indian National Committee for Space Research (INCOSPAR), which was reorganised into ISRO in 1969. All three statements are accurate, hence option (d).

Q6. With reference to the Bharatiya Antariksha Station (BAS), consider the following statements:

  1. It was announced by the Prime Minister in 2024 as India's planned indigenous space station.
  2. The first module launch is targeted for 2028.
  3. It is being built as a joint India-China space-station programme.

Which of the statements given above is/are correct?

  1. 1 only
  2. 1 and 2 only
  3. 2 and 3 only
  4. 1, 2, and 3
Show answer and explanation

Answer: 1 and 2 only

Explanation.

Statement 1 is correct. The Bharatiya Antariksha Station was announced by Prime Minister Modi in 2024 as India's planned indigenous space station. Statement 2 is correct. The first module launch is targeted for 2028, with full operational status by 2035. Statement 3 is incorrect. The BAS is an INDIGENOUS Indian programme, NOT a joint India-China space-station programme. China operates its own separate Tiangong space station; the two programmes are independent. Hence option (b).
